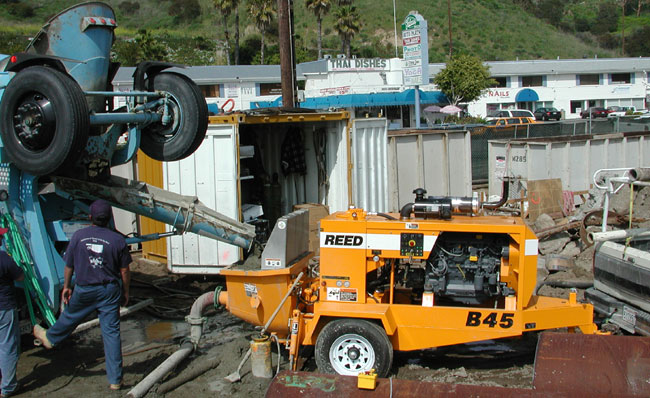

| One of the beautiful views on earth is the Pacific Ocean,  deep and blue, from the beach in Malibu.   It would be the perfect spot for home, except that, according to John  Pavalonis, “roughly every 10 years, there will be a storm that will wash away  all the sand.” Pavalonis is field supervisor for Magco Drilling, Inc., a  specialty contractor best known for caissons, shoring and elevators.  Established in 1990, Magco Drilling has built a track record for successful  drilling in limited access and low overhead conditions. This past spring, the  company pushed its skills to the limit by drilling and filling 81 heavy-duty  caissons for a multi-million-dollar home being constructed on the beach in  Malibu near Pepperdine University.  The 14,000-square-foot house is the project of Finton  Associates of Arcadia, California, which has a specialty in building custom  homes. Because the home is being built on beach sand, the entire house  —foundation, slab and all— will rest on concrete “stilts” placed by a REED B45  trailer pump.       “BORING” JOBTo construct each stilt, or caisson, Magco drilled holes  down from 0-30 ft in solid sand, and then through bedrock to depths of from  90-120 ft.
 “The water table is at 10 feet,” explains Mike Maggio,  Magco’s owner. “We had to fight water all the way, so we screwed a casing into  each hole we drilled to seal the water off.” According to Maggio, the home has a footprint that is 90 ft  from north to south and 180 ft from east to west. That includes a 30-ft by  15-ft swimming pool that is incorporated into the structure. “The house is being built on sandy soil—beach sand—and  requires a ‘starter casing.’ The drill winds a pipe into the ground down to  bedrock. The pipe keeps the sand from filling in the hole and prevents the  bedrock from caving in,” says Pavalonis. The drill bored through sand and bedrock. The crew  scooped out the rock and sand with a bucket. Then the hole was  topped off with drilling mud, which was mixed with a soda ash to raise the pH  and keep back the water while holding the hole open.
       “BORING” JOBTo construct each stilt, or caisson, Magco drilled holes  down from 0-30 ft in solid sand, and then through bedrock to depths of from  90-120 ft.
 “The water table is at 10 feet,” explains Mike Maggio,  Magco’s owner. “We had to fight water all the way, so we screwed a casing into  each hole we drilled to seal the water off.” According to Maggio, the home has a footprint that is 90 ft  from north to south and 180 ft from east to west. That includes a 30-ft by  15-ft swimming pool that is incorporated into the structure. “The house is being built on sandy soil—beach sand—and  requires a ‘starter casing.’ The drill winds a pipe into the ground down to  bedrock. The pipe keeps the sand from filling in the hole and prevents the  bedrock from caving in,” says Pavalonis. The drill bored through sand and bedrock. The crew scooped  out the rock and sand with a bucket. Then the hole was topped off with drilling  mud, which was mixed with a soda ash to raise the pH and keep back the water  while holding the hole open.  “We put drilling mud into the casing and mixed it with water  to get a slimy consistency,” says Pavalonis. “The hydrostatic pressure of the  slime coats the wall and seals it against water seepage. By exerting outward  pressure, the slime keeps the hole from caving in.”  HOT MIXOnce the hole is drilled and the sleeve casing is in place  and filled with drilling mud, Magco lowers a six-ton cage into the hole with a  crane. Then a tremie pipe of 4-in.-diameter steel is lowered through the center  of the rebar.
 The tremie allows the Magco crew to pump from the bottom up,  displacing the drilling mud as they go. As the mud rises to the top, it is  removed by a 3-in. drilling trash pump that conveys the drilling mud into a  holding tank for future use. Magco leaves the tremie pipe 4-5-ft deep into the concrete —  never above the concrete. Allowing the concrete to “free fall” from the tremie  pipe would cause it to segregate. Around 2,000 yards of concrete, provided by Associated  Ready-Mix in Ventura, were placed during the project. The mix was 5,000 psi at  27 days. The 10-sack mix had a 3/8-in. maximum aggregate.  There was little clearance for the concrete around the dense  web of reba, says Maggio. The 3/8-in. rock allowed his crew to p the concrete  in and around the rebar. “This was an extremely hot mix, stiffer and quicker reacting,  not your typical pea gravel mix,” notes Pavalonis. “The [concrete] was in the  truck an hour by the time it got here. I don’t believe a typical pea gravel  pump would have been able to handle that mix.” Maggio says that the admix helped keep the concrete from  setting up during the long drive from the batch plant, which was often  exacerbated by traffic delays.Pavalonis adds that, by regulations, they had only one  half-hour to unload the truck once it arrived at the jobsite.
 The mix was pumped with a REED B45 trailer pump, using from  120-150 ft of 3-in. line to the 4-in. steel tremie. “We ran up to 200 feet of  hose to the 120-feet of slickline,” says Maggio.  Magco could have subcontracted the pumping, but Maggio chose  to purchase a REED trailer pump, saying   “it was more convenient to actually own the pump and to know that it was  going to be there when I needed it.” This project has worked so well that  Maggio is buying a second REED. Constructing one caisson required three hours to drill out  the hole; a half-hour to place the rebar cage into the hole; and 45 minutes to  unload 10 yards of concrete from the truck…with two trucks required per 60-foot  caisson. It took approximately three months to finish the 81 caissons. When the hole was filled with concrete, wires were used to  attach the top of the starter casing to the crane, so it could be slipped out  of that hole and moved to the next one. Sand is a problem; the water table is a problem; and seismic  activity is another problem.  Concrete was pumped to about 12 feet from the top of the  caisson, at which point a metal sleeve was inserted. Then the concrete was  pumped to the stop of the sleeve and finished by hand float. To stabilize the house construction in event of earthquake,  the rebar at the opening of the caissons is attached to a grade beam. The rebar  is bent into 90-degree hooks at the top, to which the grade beams are attached. The grade beams are created by placing concrete into  rebar-filled trenches that run from caisson to caisson. This creates a concrete  gridwork that connects the piles. Concrete placed over the grade beam gridwork  will provide the slab for the house. “We used a DCI concrete additive with water proofing and  corrosion inhibiting properties,” says Maggio. “The rebar was all epoxy-coated  to prohibit corrosion. Both the admix and the epoxy-coated rebar were very  expensive. The rebar alone cost about 150 thousand dollars.” “This project required us to take things to the limit to  make it work,” notes Maggio. The experience, however, was so positive that Magco is  starting a second house down the beach from this first one. |
